Soils in Parnell differ sharply from those in South Auckland. The former sits on firm Waitemata sandstone while the latter contains deep, soft alluvial deposits. Preloading design without surcharge is the preferred method for sites where adding extra fill is impractical or restricted. This technique applies a controlled load to the ground, accelerating consolidation before construction. In the Auckland region, thick layers of compressible clays and peats demand careful analysis. We complement this with calicatas exploratorias to verify stratigraphy and ensayo CPT for continuous cone resistance profiles. The goal is predictable settlement without structural risk.
Preloading without surcharge reduces post-construction settlement by over 80% in Auckland's soft soils when monitored correctly.
Methodology and scope
Auckland's rapid urban expansion since the 1950s pushed development onto marginal land. Reclaimed waterfronts, former swamps, and floodplains now host residential subdivisions and commercial parks. These soft ground conditions are precisely why preloading design without surcharge is so effective. The method involves placing a temporary fill layer equal to the design load, then monitoring settlement until the primary consolidation is complete. Key parameters include pre-consolidation pressure, coefficient of consolidation, and secondary compression index. We use the following approach:
Site investigation with undisturbed sampling
Laboratory oedometer tests per NZS 4402
Inclinometers and settlement plates for field monitoring
This sequence ensures the design matches actual ground behavior.

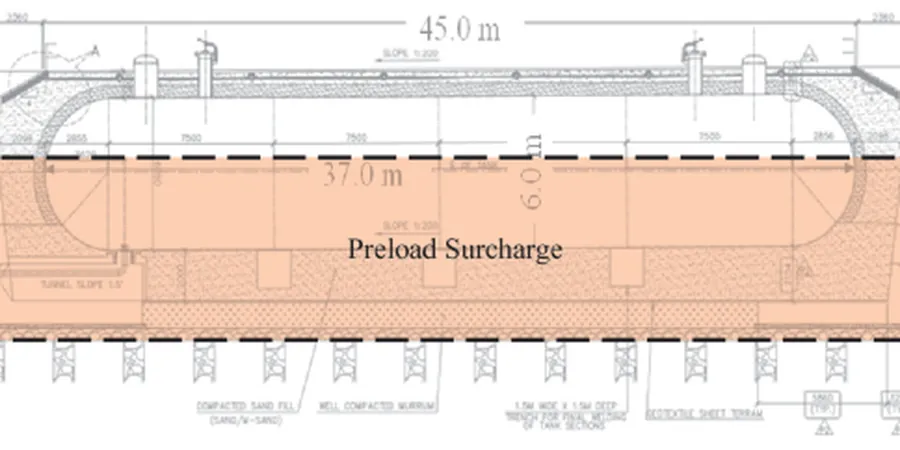

Technical reference image — Auckland
Local considerations
NZS 4203 and NZGS guidelines require that ground improvement methods demonstrate both short-term stability and long-term performance. In Auckland, the risk of differential settlement is high when preloading design without surcharge is applied to variable alluvial sequences. Layers of peat, silt, and clay can consolidate at different rates. This creates shear stresses at the interface between materials. A detailed settlement analysis using site-specific soil parameters is mandatory. We incorporate staged loading, pore pressure dissipation checks, and factor of safety against bearing failure. Without proper monitoring, the risk of unexpected post-construction settlement remains significant.
We use oedometer and triaxial test data to compute primary and secondary consolidation settlements. Output includes time-rate curves and differential settlement estimates for layered profiles.
02
Field Monitoring & Instrumentation
Installation of settlement plates, piezometers, and inclinometers to track real-time ground response. Data are analyzed to validate design assumptions and adjust fill rates if needed.
Applicable standards
NZS 4203:1992 – General structural design and actions, NZGS Guidelines for Soil Investigation, NZS 4402 – One-dimensional consolidation properties of soils
Frequently asked questions
How long does preloading without surcharge typically take in Auckland?
For most soft alluvial sites, achieving 90% primary consolidation takes 4 to 9 months. Peat layers may require up to 12 months due to their high compressibility.
What is the cost range for preloading design in Auckland?
The cost typically ranges between NZ$1,050 and NZ$3,800 depending on site area, monitoring duration, and laboratory testing volume. Complex sites with multiple layers increase the budget.
Can preloading without surcharge be used on reclaimed land?
Yes, but the design must account for variable fill thickness, buried organic layers, and potential for lateral yield. Settlement predictions are less reliable without high-quality CPT data.
What settlement tolerance is achievable with this method?
Post-construction settlements of 10–30 mm are achievable for well-designed preloading. Differential settlements can be kept under 1:500 with proper monitoring and staged loading.
